Parametric Estimating for Early-Stage Capital Projects: Methods, Models
Parametric estimating is a cost estimation technique that uses statistical relationships between project variables and historical cost data to quickly estimate project costs during early-stage planning.
At the concept stage of a capital project, the team is asked for a cost number long before there is anything resembling a design to estimate from. Scope is fluid, site conditions are assumed rather than surveyed, and engineering definition is often well below 5%. Yet sanction decisions, portfolio comparisons, and early financing conversations all depend on a credible number landing in the room. Parametric estimating exists to produce that number — fast, defensible, and anchored in historical data rather than guesswork.
Parametric estimating uses statistical relationships between project characteristics and cost to generate estimates without needing a detailed quantity takeoff. In AACE International terms, it is the workhorse method for Class 5 and Class 4 estimates, covering the 0–15% design definition band where bottom-up pricing is simply not possible. This article walks through what parametric estimating is, when to use it, the three families of models cost engineers rely on, a six-step framework for building a model that holds up under scrutiny, a worked example, and the limitations that decide whether a parametric number can be trusted.

What Parametric Estimating Actually Does
A parametric model replaces the estimator’s quantity-by-quantity buildup with a cost-estimating relationship — a CER — derived from past projects. Instead of pricing every foundation, every cable run, every cubic metre of concrete, the estimator identifies the one or two characteristics that most strongly predict total cost and applies a statistically fitted rate. The method trades precision for speed, and on well-scoped asset classes it trades surprisingly little.
The relationships cost engineers use every day are straightforward in form but powerful in practice. Buildings are priced per square metre of floor area. Highways are priced per kilometre. Power plants are priced per megawatt of installed capacity. Process plants are priced per tonne-per-year of throughput. Pipelines combine diameter and length. The table below shows the most common pairings.
| Project Type | Parametric Variable | Typical CER |
|---|---|---|
| Commercial buildings | Gross floor area | Cost per m² |
| Highways | Centreline length | Cost per km |
| Power generation | Installed capacity | Cost per MW |
| Mining and processing | Annual throughput | Cost per tonne per year |
| Pipelines | Diameter × length | Cost per inch-km |
A worked-through application is equally simple. For a 20,000 m² commercial office at a fitted rate of $2,800/m², the parametric estimate is $56 million. The number is defensible because the rate was derived from comparable completed buildings, not pulled from a benchmark report. That provenance — the ability to point at the sample the rate came from — is what separates a parametric estimate from a guess.
Where Parametric Estimates Are Used
Parametric methods dominate the front end of the capital project lifecycle. They are the primary tool for concept screening, where a team is comparing five or ten options and needs rough numbers on each before narrowing the field. They carry most of the cost work through pre-feasibility, where technical alternatives are compared on capital and operating cost on a like-for-like basis. They still form the backbone of many feasibility-stage estimates, particularly for projects where historical data is dense and the technology is standardised.
In the AACE International classification, this maps cleanly onto Class 5 estimates — 0–2% design definition — and Class 4 — 1–15% definition. At these stages, material quantities are not yet taken off, engineering design is incomplete, and construction methods are assumed rather than specified. Bottom-up estimating is not an option because there is nothing to build up from. Parametric estimating provides an order-of-magnitude number quickly enough that sanction committees can compare options in a single meeting, and defensibly enough that those comparisons stand up to later scrutiny.
The Three Families of Parametric Models
Parametric models span a spectrum of complexity. At the simplest end sit unit rate models — a single multiplier applied to a single driver. Highway cost equals road length times cost per kilometre. A 50 km road at $6M per km estimates $300 million. Unit rates are appropriate when the driver dominates cost and the project sits inside the range of the supporting dataset. They break down when scope varies materially or when the project pushes outside the data envelope.

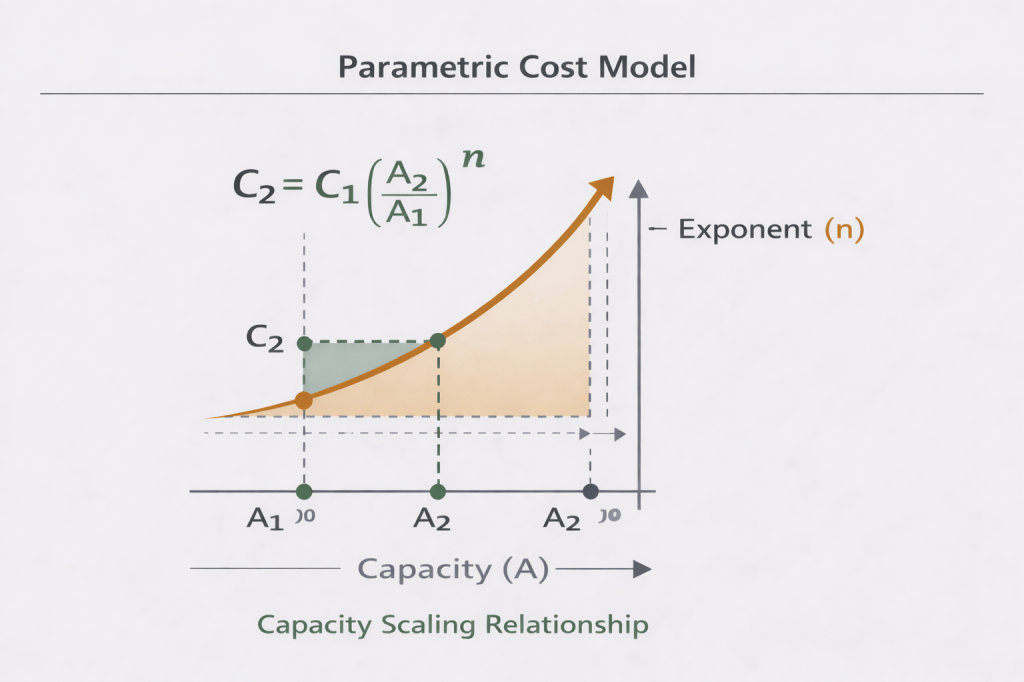

Capacity factor models sit in the middle of the spectrum and are the workhorses of industrial and process estimating, because they capture economies of scale that unit rates assume away. The canonical form is Cost₂ = Cost₁ × (Capacity₂ / Capacity₁)^n, where the scaling exponent n typically lands between 0.6 and 0.8 — the “six-tenths rule” in process plant estimating. If a 100,000 tonne-per-year processing plant cost $200M, a 200,000 tonne-per-year plant at an exponent of 0.65 estimates to $200M × 2^0.65 ≈ $314M, not $400M. Doubling capacity rarely doubles cost, and the exponent is what tells the estimator by how much.
Regression models sit at the far end, combining multiple drivers into a fitted equation of the form Cost = a + b₁(Capacity) + b₂(Site Complexity) + b₃(Location Factor). Regression approaches are the standard for large engineering firms, infrastructure agencies, and mining developers with sufficiently deep project databases to support them. They are powerful when the data is clean and plentiful, and dangerous when either assumption fails. A poorly specified regression can look authoritative while being systematically biased.

Building a Parametric Model That Holds Up
A parametric model that will be used in sanction papers has to be built deliberately, not assembled from convenient benchmarks. A workable framework moves through six steps, and each one is load-bearing. Start by defining the cost variable precisely — total installed cost, EPC cost, or equipment-only cost behave very differently, and mixing them silently across the dataset is the most common source of a biased model. Next, identify cost drivers that are measurable at early stage, strongly correlated with cost, and available before engineering begins: floor area, installed capacity, length, throughput.
The third step is collecting historical project data, ideally from internal archives where scope and cost are well understood, supplemented by contractor bids and public infrastructure cost databases. The fourth — normalising — is where most models are saved or ruined. Raw costs must be escalated to a common year, adjusted for location using regional labour and productivity factors, trimmed to a consistent scope envelope, and converted to a single currency. Without normalisation, a model built from projects spanning a decade and three continents will produce confident-looking nonsense.
With clean data in hand, fit the parametric relationships — a simple ratio, a scaling exponent, or a multi-variable regression depending on the data density. Excel handles the first two; Python or specialised cost software is worth the effort for the third. Finally, validate the model by holding out projects from the fitting set and comparing predicted to actual cost, analysing residual error by project type and vintage, and testing behaviour at the edges of the data range where the model is weakest.
A Worked Example and Where Parametric Estimates Fail
Consider a conceptual 150 MW utility-scale solar farm. A regional CER for similar projects gives $1.1M per MW installed, producing a base estimate of 150 × $1.1M = $165M. That number is then adjusted for project-specific factors: +8% for a remote location, +5% for challenging soil conditions, +4% for inflation escalation to the execution year. Applied multiplicatively against the base, the adjusted estimate lands at roughly $165M × 1.17 ≈ $193M. The entire calculation takes hours. A detailed estimate at the same stage would take weeks and would not be meaningfully more accurate, because the underlying scope uncertainty dominates both methods.
The caveats matter. Parametric estimates fail when the historical data is incomplete, when the chosen drivers are weakly correlated with cost, when scope differences between past and current projects go unadjusted, or when normalisation is skipped. They fail silently — the model still produces a number, and the number still looks reasonable, but the confidence interval around it is far wider than anyone reporting it assumes. Experienced estimators guard against this by pairing the model output with a sanity check against benchmark ranges, by maintaining the dataset as a living asset rather than a one-time build, and by treating the parametric number as an input to professional judgment rather than a substitute for it.

Key Takeaways
- Parametric estimating produces fast, defensible conceptual estimates using statistical relationships between project drivers and cost, covering the 0–15% design-definition band where bottom-up estimating is impossible.
- Three families of models cover most situations: unit rates for simple, well-understood assets; capacity factor models with 0.6–0.8 exponents for industrial and process plants; regression models for data-rich portfolios.
- Model quality depends almost entirely on the historical dataset — its size, its normalisation, and how closely past projects match the project being estimated.
- Normalisation for escalation, location, scope, and currency is not optional; skipping it is the single most common source of systematic error.
- The parametric number is an input to professional judgment, not a replacement for it; validate against benchmarks and pair with estimator experience before taking it to a sanction committee.
